Jenrick Allows Two Further Large London Appeals, With Costs

Exactly a week after the Westferry Printworks decision letter (see my previous blog post) on 22 January 2020 the Secretary of State allowed two further appeals in relation to significant London residential development projects, this time both decisions following his inspectors’ recommendations, and with costs awards in favour of the appellants, again as recommended by his inspectors.

Given that an award of costs can basically only be made on the basis of unreasonable behaviour by a party to the appeal (see the detailed advice in the Government’s Planning Practice Guidance), lessons plainly need to be learned – in fact what happened in both cases was pretty shocking.

North London Business Park site, Barnet

This was an appeal by Comer Homes Group against Barnet Council’s refusal of a hybrid application for planning permission for the phased comprehensive redevelopment of the North London Business Park to deliver a residential led mixed-use development:

• detailed element comprising 376 residential units in five blocks reaching eight storeys, the provision of a 5 Form Entry Secondary School, a gymnasium, a multi- use sports pitch and associated changing facilities, and improvements to open space and transport infrastructure, including improvements to the access from Brunswick Park Road, and

• outline element comprising up to 824 additional residential units in buildings ranging from two to eleven storeys, up to 5,177m2 of non-residential floorspace (Use Classes A1-A4, B1 and D1) and 2.9 hectares of public open space, associated site preparation/enabling works, transport infrastructure and junction works, landscaping and car parking.

This is the Secretary of State’s decision letter and inspector’s report in relation to the appeal and this is the Secretary of State’s decision to make a full costs award against the council, following the inspector’s recommendations.

Members had refused the application against officers’s recommendations.

The council’s failing is set out starkly in the inspector’s costs report: no proper evidence was adduced to support its decision:

Mr Griffiths, Principal Planning Officer at the Council of the London Borough of Barnet, was the Council’s only witness at the Inquiry. He stated, in his proof of evidence, that “It is not the intention for this document to represent my professional opinion and the evidence presented represents the views of elected members of the London Borough of Barnet Planning Committee”.

The proof of evidence focusses on a particular view contained within a TVIA submitted by the Applicant and states that “Within View 11, the 8-storey height of Blocks 1E and 1F stands in harmful juxtaposition with the two-storey height of the properties on Howard Close”. But the proof acknowledges “…that buildings of up to 7 storeys in height could be acceptable in this location therefore it is pertinent to outline the additional harm that would arise from the 8 and 9 storey buildings proposed within the development and why these heights are unacceptable”.

The written evidence fails to substantiate why the extra storey on Blocks 1E and 1F would cause harm and fails to consider the effect of buildings over seven storeys in height elsewhere in the development. The proof simply repeats the assertion made in the sole reason for refusal of the application that “The proposed development, by virtue of its excessive height, scale and massing would represent an over development of the site resulting in a discordant and visually obtrusive form of development that would fail to respect its local context…to such an extent that it would be detrimental to the character and appearance of the area”.

Under cross examination Mr Griffiths refused to answer some questions put to him and to give his professional view on the effect of the proposed development on the character and appearance of the area. The Appellant was not thus afforded the opportunity, at the Inquiry, to explore the unsubstantiated assertions made in the proof of evidence and did not learn anything more about members concerns. Crucially, no member of the Planning Committee appeared at the Inquiry to substantiate their views that was unsubstantiated in the proof of evidence.

The Council has failed to produce either written or verbal evidence to substantiate the reason for refusal of the application, and has provided only vague and generalised assertions, unsupported by an objective analysis, about the proposed development’s impact. The Council has behaved unreasonably and the Appellant has incurred unnecessary expense in the appeal process. A full of award of costs against the Council is justified.”

It was hardly surprising that the Secretary of State decided to allow the appeal:

“32. The development plan restricts tall buildings to identified locations, and the proposal would include them on a site not identified as suitable for them. This conflict carries significant weight against the proposal.

33. The proposal has been designed to respect the existing character of the local area, while maximising the potential for delivering homes. It would deliver a replacement secondary school alongside new open space, sports facilities and community space. The local authority is unable to demonstrate a five-year supply of housing land without taking account of this site, and the proposal would provide 1350 new homes. The provision of the housing and the ancillary facilities both carry significant weight in favour of the proposal.

34. The Secretary of State considers that there are material considerations which indicate that the proposal should be determined other than in accordance with the development plan, and therefore concludes that the appeal should be allowed and planning permission granted.”

The inquiry sat for four days in October and November 2018 (why the inordinate delay since then?), with the appellant team comprising Christopher Katkowski QC and Robert Walton (now QC), calling four expert witnesses. The costs award will amount to a sum that would be ruinous for many private sector bodies, well into six figures – because council members took a decision without evidence and without considering whether proper evidence, or a different approach, might be required in the face of an appeal. And a scheme for well over a thousand homes and a school (first applied for in December 2015!) has been delayed for absolutely no reason.

Conington Road, Lewisham

This was an appeal by MB Lewisham Limited against Lewisham Council’s decision to refuse its application for planning permission for the construction of three buildings, measuring 8, 14 and 34 storeys in height, to provide 365 residential dwellings (use class C3) and 554 square metres (sqm) gross of commercial/ community/ office/ leisure space (Use Class A1/A2/A3/B1/D1/D2) with associated access, servicing, energy centre, car and cycle parking, landscaping and public realm works.

This is the Secretary of State’s decision letter and inspector’s report and this is the Secretary of State’s decision to make a partial award of costs against the Mayor of London, and inspector’s report.

The procedural position here was a little more complicated. After Lewisham had refused this application, the applicant had submitted a further application for planning permission which sought to address the reasons for refusal. The scheme would secure 20.19% affordable housing by habitable room, which the council accepted, on the basis of viability appraisal, was more than the maximum reasonable provision. The Council resolved to approve the application but the Mayor directed refusal, not satisfied that the viability work justified that level of affordable housing.

By that time the first application had been refused and the appellant revised the scheme to reflect the changes introduced into the second application. Accordingly, whilst the appeal was technically against Lewisham’s initial decision on the first application, in reality the only live issues were those raised by the Mayor on affordable housing and viability, including whether a late stage review mechanism was necessary in line with its policy requirement.

I suspect that you needed to be at the inquiry to appreciate the full horror as events unfolded (I wasn’t) but it appears that the viability case against the appellant’s position completely collapsed at the inquiry following exchange of evidence and cross-examination by Russell Harris QC. But that wasn’t the only problem. Presumably to save costs, the council and the Mayor both engaged the same advocate at the inquiry and, once it understood the real position on viability, the council wished to concede various issues but the Mayor was not willing so to do, meaning that the advocate immediately had a conflict of interest and, mid-inquiry, had to recuse herself from acting for the Mayor! The Mayor’s team continued to participate in the inquiry but without challenging the evidence provided by the appellant.

This is from the inspector’s report on the appellant’s costs application:

On day 2 of the Inquiry, following cross-examination of the Council’s construction costs witness Mr Powling, the advocate representing the Council and the Greater London Authority (GLA) advised that due to a conflict of interest, the GLA would no longer be represented. The GLA however wished to continue with their objections as an unrepresented principal party. Later in the afternoon, following cross-examination by the appellant of Ms Seymour for the GLA, the Council formally withdrew its objections to the proposal on viability grounds. The Council took no further part in the Inquiry.

Where the operation of a direction to refuse is issued, the GLA is to be treated as a principal party. Without the GLA direction, the London Borough of Lewisham (LBL) would have granted a planning permission for a now identical scheme. This appeal only arises thus as a result of the change of the resolution to grant to reflect the terms of the GLA’s direction.

6. In its letter to the Inspectorate indicating its intention to attend, the GLA made it clear that was prosecuting its direction in terms and was expecting LBL to do the same. Therefore for all practical legal and policy purposes, the GLA must be treated as a main party prosecuting the terms of its direction at this appeal. Without that direction LBL would not have opposed this scheme and this inquiry would not have been necessary.

7. Their conduct therefore falls to be considered in accordance with the provisions for principal parties.

8. Its conduct was unreasonable in substantive terms in relation to its directed main reason for refusal. Its conduct during the inquiry was also unreasonable. Both levels of unreasonableness resulted in the inquiry and the appellant having to incur significant unnecessary expense in relation to the affordable housing issue.

9. In substantive terms, the GLA produced no evidence which met or came close to the requirements of the PPG on the issue of construction costs to support its reason for refusal.

10. Its ‘evidence” failed to meet the threshold properly to be called “evidence” It failed to engage with the agreed evidence of others that the construction costs were fair and reasonable and during the proceedings failed to read understand or engage with evidence which clearly established that its evidence was incorrect and unreasonable.

11. In terms of the double count issue, the GLA persisted with its case irrespective of evidence suggesting that it was wrong and in an unreasonable fashion after the only other relevant party advised by Leading Counsel had accepted that the point was simply not properly arguable. It chose not to read and understand the clear evidence, notwithstanding it had insisted on the reason for refusal and that it be a party at the inquiry.”

The Greater London Authority shall pay to MB Homes Lewisham Ltd its partial costs of the inquiry proceedings, limited solely to the unnecessary or wasted expense incurred in respect of the costs of the appeal proceedings related to dealing with the issue of affordable housing after the Council decided not to represent the Greater London Authority, such costs to be taxed in default of agreement as to the amount thereof.”

Oof!

The Secretary’s conclusions on viability were as follows:

“17. The Secretary of State agrees with the Inspector that the essential differences on viability between the parties lies in a variation of around £11m in construction costs (including fees and profit); and private residential values (IR127).

Construction costs

18. The Secretary of State notes that CDM (for the GLA) consider build costs to be overstated (IR129). However, the Secretary of State also notes that independent costs estimates produced by 3 firms of costs consultants were within 2 percentage points of each other. He agrees with the Inspector that no evidence has been produced in any later analyses to show that those build costs, or any element of them considered for viability purposes, are unreasonable (IR128-131).

Fees

19. The Secretary of State notes that the level of fees remained a point of difference at the beginning of the Inquiry. The Secretary of State also notes that while detailed analysis of this issue did identify an overstatement of fees of less than £1m, this is far below the overstatement claimed by the Council and GLA. He further notes that, at the Inquiry no evidence was forthcoming from the GLA’s costs witness, CDM, to support their contention that preliminaries are set too high or that the level of professional fees of around 10% would be excessive for a project of this nature. In addition, the Council’s costs witness accepted that if a reasonable preliminaries figure of 17% or so was adopted then the whole argument in support of the £5.5m fees deduction from the overall level of costs fell away (IR132-133).

Profits

20. For the reasons given in IR134-135, the Secretary of State agrees with the Inspector that the proposed profit levels are reasonable for this scheme.

21. For the reasons given in IR136 the Secretary of State agrees with the Inspector that no evidence was offered by the Council or the GLA to counter the appellant’s build costs analysis or the level of fees or profit.

Private residential values

22. The Secretary of State has carefully considered the Inspector’s analysis in IR137-146 and agrees that the GLA’s suggested values would be unlikely to be achievable in the market (IR144).

23. The Secretary of State also notes that the GLA accepted at the Inquiry that if the £11m alleged surplus on fees and construction costs did not exist, then the claimed remaining £900,000 (IR132) would not have led to a direction to refuse from the Mayor’s office (IR146). For the reasons in IR147, the Secretary of State agrees with the Inspector that the 20.2% affordable housing proposed by the appellant is the maximum, if not somewhat more, than what can be reasonably provided, and he accordingly attaches very considerable weight to this benefit of the proposal. He finds no conflict with the requirements of LonP policy 3.12; the Mayor’s Affordable Housing and Viability SPG, Lewisham CS policy 1 and DMLP policy DM7.

Late stage review

24. For the reasons given in IR148-149, the Secretary of State agrees with the Inspector that there is no pressing case for a late stage review for a scheme such as this, where development is proposed to be completed in a single phase. He finds no conflict with the requirements of LP policy 3.12, the Mayor’s Affordable Housing and Viability SPG, Lewisham CS policy 1 and DMLP policy DM7.

“In favour, the Secretary of State affords very considerable weight to the provision of market and affordable housing. He also affords moderate weight to the positive contribution to the character and appearance of the emerging Lewisham Town centre.”

And no late stage review!

In amongst the horror show for both the council and the Mayor seems to have been some simple lack of communication as between their witnesses. Quoting from the inspector’s summary of Lewisham’s case:

When the appellant’s viability proof was received and reviewed it did not appear that the short reference in paragraph 7.2 to the Gardiner & Theobald review report raised any pertinent issue. This was particularly so as the proof suggested that the appellant’s basis for assessment of costs was unaltered.

As a consequence the Council’s viability witness did not send its costs witness the appellant’s viability proof (which dealt with numerous other issues not relevant to costs estimates). On review at the Inquiry, the Council’s build cost estimate was revised from £107,179,737 to £111,809,368 representing a difference of £4,629,631. The consequence of this was that it changed appraisal A – 2018 Residential Pricing to negative £1,155,982 and Appraisal B – 2017 residential pricing (less HPI) reduced to £ 3,111,251. This still represents a £20m disparity approximately with the appellant’s viability conclusions. It nonetheless reduced the margin of surplus on the Council’s assessment to fall within an acceptable margin of error“.

Oof.

Where would we be without the ability properly to test evidence at inquiry?

Simon Ricketts, 25 January 2020

Personal views, et cetera

PS not to be too London-centric, I should add that on the same day the Secretary of State also allowed an appeal for 850 homes near Tewkesbury.

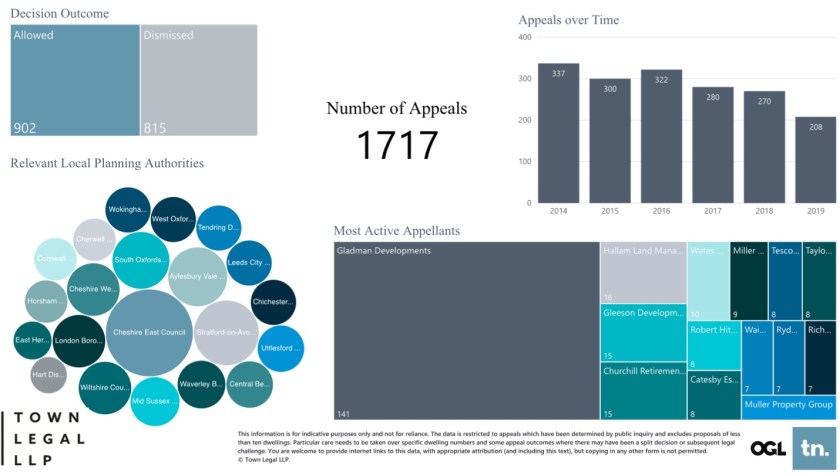

The appeal stats for 2020 are already going to look more healthy than those for the last two years, which become apparent if you interrogate our Town Legal 2014-2019 housing inquiry appeals data visualisation tool.

Westferry Printworks Decision: LPA Reaction Unprintable

Tower Hamlets Council’s revised CIL charging schedule came into effect on 17 January 2020, imposing borough CIL for the first time on its large allocated sites, so you will appreciate its double disappointment at the Secretary of State allowing the Westferry Printworks site appeal, against the inquiry inspector’s recommendations, in a decision letter dated 14 January 2020. The CIL figure could have been up to £50m, according to evidence given at the inquiry on behalf of the appellant.

The scheme is for a “comprehensive mixed-use redevelopment comprising 1,524 residential units (Class C3), shops, offices, flexible workspaces, financial and professional services, restaurants and cafes, drinking establishments (Classes B1/A1/A2/A3/A4), community uses (Class D1), car and cycle basement parking, associated landscaping, new public realm and all other necessary enabling works” at Westferry Road on the Isle of Dogs.

There has been a furious response from the council. At a full council meeting the following day, 15 January 2020, a resolution was passed to examine “all available options, including a judicial review“. The East London Advertiser reports Mayor John Biggs as saying:

It is a massively tall and dense development. Something of 40 floors on the island is an outrage. By making the decision on Tuesday we also lose a massive sum of money. This development will place a huge impact on the island. It is a scandal and outrageous. We will be doing everything in our power [including] seeking a judicial review.”

The potential impact of borough CIL on the viability of the proposals obviously had been raised by the appellant as a potentially relevant matter, given that it would go to viability. Unsurprisingly, the appellant had sought to include a mechanism within its section 106 agreement for a potential reduction in affordable housing should the Secretary of State’s decision letter be issued after the revised CIL charging schedule had been adopted, a proposal which both the inspector and Secretary of State rejected.

The timing of the decision letter meant that this issue went away – it would have been an interesting one to test, given that the situation often arises where an applicant or appellant is in the hands of the decision maker as to whether permission will be issued before a revised CIL charging schedule comes into effect and why shouldn’t a section 106 agreement mechanism to neutralise the effect be appropriate where the viability appraisal has not taken the potential additional CIL liability into account?

The decision letter was plainly ready to be issued, why should it have been held back?

The appeal had been lodged in relation to an application submitted by Westferry Developments Limited (the owner of the site is Northern & Shell, the development manager is Mace) on 24 July 2018. The appeal was recovered for the Secretary of State’s own determination on 10 April 2019. Tower Hamlets asked for more time to formulate their position in relation to the proposals but this was refused by the Secretary of State, as recorded in a report to a meeting of Tower Hamlets’ strategic development committee on 14 May 2019:

This report is seeking the authority of the committee for officers to defend an appeal which has been submitted to the Secretary of State by the developer. The Secretary of State has imposed a timetable which requires that this report is considered by the Committee on 14th May 2019 in time for the council to submit a Statement of Case by 22nd May 2019 in order to avoid breaching the imposed timetable and making the authority liable for costs for unreasonable behaviour. As the report had not been written when the timetable was imposed, the Council asked Secretary of State to review the timetable and he has declined. These are the special circumstances justifying the urgency.”

The previous Mayor of London (whatever happened to him?) had intervened and granted planning permission for an earlier scheme for the site in 2016 for “comprehensive mixed use redevelopment of 118,738 m2 including buildings ranging from 2-30 storeys (tallest 110 m AOD) comprising: a secondary school, 722 residential units, retail use, restaurant and cafe and drinking establishment uses, office and financial and professional services uses, community uses, car and cycle basement parking, associated landscaping and new public realm“. That planning permission has been implemented by the demolition of the printworks and works to construct a new basement.

The latest application had been on the basis of an offer of 35% affordable housing, although not policy compliant due to the proposed tenure mix, justified by reference to viability appraisal. When the appeal was submitted, unsurprisingly, given that on appeal the decision maker would expect an updated viability appraisal, that offer was withdrawn and at the time of the 14 May 2019 committee meeting there was just an indication that a revised viability assessment would be submitted and that the revised offer would be less than 35%.

The committee resolved that the proposals would have been refused on the following grounds:

⁃ Townscape and visual impact

⁃ Wind Impact on the Docklands Sailing Centre

⁃ Affordable housing – amount

⁃ Housing mix and choice

The inquiry started on 7 August 2019. This was an important appeal for the council, as can be seen from this July 2019 Facebook post from a councillor, encouraging opposition to the proposals:

In the evidence for the inquiry, the affordable housing offer had been reduced to 21% on the basis of an updated viability assessment.

In this summary that follows I am plagiarising some of an internal note prepared by my Town partner Louise Samuel (into which I may now introduce errors, all mine):

• The inspector accepted that the existing permission should be treated as a fallback, which formed an appropriate basis for assessing an alternative use value for the purposes of arriving at a benchmark land value.

• However, the inspector did not agree with how the appellant had calculated the benchmark land value (see IR 507 on for BLV discussion) and considered that the 21% offer was unlikely to be the maximum reasonable provision for the site. He did not, however, set what the maximum reasonable provision would be.

• Whilst Tower Hamlets criticised the appellant for resiling from its previous 35% offer, the Inspector notes that it was clear that the appellant was responding to the Mayor’s fast-track approach (which requires at least 35%) and so took a commercial view despite the fact that it was not supported by the viability assessment at the time. He concluded that this was not, in itself, a reason to reduce the weight to be attached to the Assessment before him (see para 530 of the IR).

• The Inspector’s view was that the consented scheme provided many of the same benefits but without causing the same harm to heritage assets. Because of the consented fallback, the only benefits that carried weight were those in addition to the consented position.

• The Secretary of State agreed that it is likely that the scheme could provide more affordable housing (“21% does not…represent the maximum reasonable amount of affordable housing”) but still considered that the additional benefits (compared to the consented fallback scheme) of: (a) housing (802 more units of which 142 would be affordable, with a policy compliant tenure split of 70% affordable rent 30% intermediate); and (b) employment during construction, were enough to grant permission. The Secretary of State gave these benefits significant weight whereas the Inspector had attached moderate weight to these benefits. The Secretary of State took into account that “there is no evidence before him of any other scheme which might come forward or what level of affordable housing might be delivered by any such scheme”.

• The Secretary of State considered these benefits to be enough to outweigh harm to important heritage assets (Grade I Old Royal Naval College; Grade I Tower Bridge; and the Greenwich World Heritage Site).

• The section 106 agreement included both an early and late stage viability review, which means that the percentage of affordable housing may increase, albeit the Inspector criticised the limited effectiveness of these.

An interesting decision in that we would need to go back almost two years to find another recovered appeal for housing development which the Secretary of State has allowed in London. Contrast for instance with the 19 July 2019 Chiswick Curve decision letter, appeal dismissed by the Secretary of State against his inspector’s recommendations, where he gave only moderate weight to the provision of 327 dwellings, whereas the Inspector had given significant weight to the housing offer (the decision has been challenged by the appellant – Louise and colleagues acting), and contrast with for instance the 1 Cambridge Heath Road 10 June 2019 decision letter, again an appeal dismissed against his inspector’s recommendations.

Much to chew over for those promoting, or otherwise engaged with, major projects in London.

Simon Ricketts, 18 January 2020

Personal views, et cetera



Image courtesy of Westferry Printworks website

Feels Like We Only Go Backwards: Wealden, South Oxfordshire & Eastleigh Local Plans

It feels like I only go backwards, baby

Every part of me says, “Go ahead”

I got my hopes up again, oh no, not again

Feels like we only go backwards, darling

The seed of all this indecision isn’t me, oh no

‘Cause I decided long ago

But that’s the way it seems to go

When trying so hard to get to something real, it feels

(Tame Impala)

An Australian band singing about English local plans?

Wealden local plan

First the Sevenoaks plan was knocked back on failure of the duty to cooperate (see my 26 October 2019 blog post More Plans Grounded: West Of England; Sevenoaks; London), now Wealden.

As always, it is interesting to start with the “taking the moral high ground” toned press statement.

Throughout the Local Plan process, we have always tried to find the right balance between the need for growth in housing and employment land, and the need to protect our unique environment,” said Councillor Bob Standley, Leader of Wealden District Council.

“Our approach to protect the environment has been supported by our Councillors and many of our residents.

“Unfortunately, the Planning Inspector, following last summer’s Examination in Public of our Local Plan, has found that we put too great an emphasis on protecting the environment and that we need to do more to build houses in Wealden which our neighbouring councils cannot accommodate.

“Regrettably, this will inevitably have impacts on our communities. We acknowledge that there is already significant pressure on infrastructure; such as roads, doctors, dentists, schools and sports facilities. A requirement to build more homes will only have a greater impact on those facilities, which will require further investment.”

(Wealden District Council’s 6 January 2020 press release).

It is interesting then to turn to the forensic dissection of the council’s approach, its multiple failings laid bare in the inspector’s 20 December 2019 letter.

I wrote about Wealden’s previous run-ins with Natural England, adjoining authorities and the courts, all basically about the extent that the council is entitled to rely on environmental concerns to reduce housing numbers within its district, in my 8 April 2017 blog post Heffalump Traps: The Ashdown Forest Cases.

South Oxfordshire local plan

My 12 October 2019 blog post SOx On The Run explained the background to the Government’s intervention to prevent the new Lib Dem administration at South Oxfordshire from withdrawing the plan which the previous Conservative administration had submitted for examination.

Secretary of State Robert Jenrick has now written on 6 January 2020 to the council indicating that he is considering whether to use powers to ask Oxfordshire County Council to prepare the Plan.

In this context, I would like to take this opportunity to ask you to outline by 31st January 2020, if there are any exceptional circumstances as to why you do not have a plan in place that I should take into account when I make a decision on next steps.”

Eastleigh local plan

Eastleigh Borough Council is in the middle of an examination of its submitted local plan. It has not been uncontroversial locally:

Hundreds of campaigners, along with local TV crews, converged on the Botleigh Grange Hotel yesterday morning as Action Against Destructive Development (ADD) staged a demonstration on the second day of the public examination of Eastleigh’s Council’s Local Plan.

Organisers estimated 400 hundred people had braved the rain to attend the early morning “show of strength” as residents from Eastleigh’s Northern and Winchester’s Southern parishes united in opposition to council plans to build thousands of new homes and a motorway link road in countryside just North of Bishopstoke and Fair Oak.  It was reported that so many people had turned up, some were forced to park at the Ageas bowl two miles away.”

(from Hundreds protest at Local Plan hearing Eastleigh News, 23 November 2019).

31 year old career politician Paul Holmes was elected to represent the Eastleigh constituency in the December 2019 general election, replacing fellow Conservative Mims Davies, who is now MP for mid-Sussex. Ms Davies was a long-time opponent of the (Lib Dem) council’s plans – indeed oddly (and surely contrary to convention) there are still campaigning pieces by her about Eastleigh on her official website despite now representing another constituency:

Our community must be heard. Real democracy is missing across Eastleigh in the local planning process. Our beautiful green spaces are under direct threat from the plans of the Council. We need to use brownfield land first. That is why I joined with community groups to make a strong submission to the Eastleigh Local Plan process. The Council should serve Eastleigh residents and not developers.”

Mr Holmes has picked up the reins from Ms Davies with some verve…

Indeed he asked a question about the local plan at Prime Minister’s Questions on 8 January 2020:

My right hon. Friend has always been a vocal advocate of localism, so what advice can he give to my constituents who are concerned about the local Lib Dem council’s unwanted housing plan in Eastleigh, which would lead to even more overdevelopment without securing the vital infrastructure that Eastleigh needs?

The Prime Minister’s response:

I am not surprised by what my hon. Friend says about the cavalier behaviour of the Lib Dem council in Eastleigh. We will ensure that, in so far as we need to build many more homes, which we do, we will supply the infrastructure necessary and do it on brownfield sites.”

(Sigh, that brownfield sites reference. That’s what they all say, isn’t it? What did Mr Holmes do on the very first day in his new job? He objected to proposed development on just one such brownfield site, the GE Aviation site in Hamble Lane, and the application was duly refused by members in spite of officers’ recommendation to approve).

I wrote about other examples of MPs intervening in local plan processes in my 13 July 2019 blog post Less Than Best Laid Plans: Political Pragmatism.

Let’s leave local plan examinations to the examiners!

Simon Ricketts, 11 January 2020

Personal views, et cetera

Image from Tame Impala video for Feels Like We Only Go Backwards.

Elephant, Dove, Old Oak, RICS

I thought I would start 2020 by trying to establish some common ground, before then mentioning what happened shortly before Christmas in relation to the Elephant & Castle and Old Oak projects, both controversial in different ways. The questions are long but I hope that the answers are short.

Do we all agree that…

1. more housing is needed for those who cannot afford homes that are being built by the private sector in their local area, even when these are required to be sold or let at significant discounts to market rates – and that what we call that housing (eg social housing/socially rented) and the nature of the body that delivers and manages it (housing associations or other registered providers, local authorities) are secondary issues?

2. the current system of seeking to require developers to deliver that housing (whoever then manages it) is not working and is hugely inefficient, in that: (1) local policy expectations set out in local plans are often not met, due to those expectations being determined not to be viable – leading to prolonged negotiations and local objection (2) the complexities and multitude of inputs to any negotiated section 106 affordable housing package, often including intricate mechanisms to provide for later reviews of the viability position, are at best a costly distraction for all parties (needing to be tooled up with valuation and QS professionals) and at worst are prone to lead to huge delays and, over time, the prospect of renegotiation where the negotiated outcome is not sufficiently attractive to funders, or where (almost inevitably) circumstances have changed during the long course of the process?

3. it is in the public interest for communities within developments to be socially and economically diverse?

4. the system worked more easily when much more Government money was available to support affordable housing by way of grant (without grant obviously a requirement to deliver social housing has a huge impact on the viability of a scheme) and that we need to get back to a system that (1) is simple (2) delivers housing that is truly affordable for those who need it (3) is efficient and (4) does not delay development more generally?

5. government (ie our) money needs to be spent where it can have most beneficial impact and is most needed?

There has been a lot of government tinkering but don’t we have to get back to those fundamentals? I’m not sure that the Government’s promised Social Housing White Paper is going to get us there, given the absence of relevant detail about affordable housing in the Conservatives’ manifesto – talk about owning first homes is a world away from the very different challenges faced by so many.

I’m sorry to be a cracked record – see my 28 May 2017 blog post Affordable Housing Tax or 4 November 2017 blog post Viability Assessment Is Not A Loophole, It’s A Noose. We could look at the idea of expanding CIL to include a social housing contribution, so that local authorities can deliver or procure it, with the option of provision on site counting as works in kind? But I’ve previously been against further rolling out another complex and inefficient regime, ie CIL, and most authorities, hollowed out and stretched as they are, are not currently in any position to deliver or procure social housing at scale. Instead, personally I would simply prefer that we go back to the old way – grants to providers so as to reduce the impact on viability for the developer of providing social housing.

In the meantime, we have to make the current system work. My 8 June 2019 blog post The Bottom Line: Updates On CIL And Viability reported on the RICS professional statement on financial viability in planning, which came into effect on 1 September 2019, and mentioned the revisions made to viability passages of the PPG by the Government on 9 May 2019, reflecting changes to the NPPF that seek to ensure, amongst other things, that detailed viability examination takes place at plan-making stage rather than when applications come forward.

The RICS professional statement sets out the professional responsibilities of the surveyor in the viability appraisal process, to seek to ensure that the surveyor operates with professional independence and integrity throughout. The RICS is now consulting from 13 December 2019 until 9 February 2020 on a draft guidance note Assessing financial viability in planning under the National Planning Policy Framework for England, 1st edition that seeks to set out the methodology to be applied by those professionals, so as to give effect to Government policy.

We are not seeking comments contrasting the government framework with a market-based appraisal. Comments should focus on whether our draft guidance gives effect to government policy and practice guidance, in an administratively efficient way, in order to deliver the objectives of the NPPF.”

Make your views known.

In the meantime…

Elephant & Castle

Delancey’s proposed redevelopment of the Elephant & Castle shopping centre and London College of Communication has long been controversial. It proposes a large mixed-use development comprising a range of buildings of up to 35 storeys, with a mix of uses including 979 dwellings (proposed to be for rent rather than sale) and accommodation for retail, office, education, assembly and leisure along with a remodelling of the London Underground station. One of the lines of attack for objectors, including the 35% Campaign, has been the perceived lack of “genuinely affordable” housing.

Planning permission was granted by the London Borough of Southwark on 10 January 2019. Just before Christmas, in Flynn v London Borough of Southwark (Dove J, 20 December 2019), the High Court rejected a crowdfunded challenge to the permission brought on behalf of the 35% Campaign. The grounds of challenge all turned on the affordable housing deal that Southwark struck in the section 106 agreement with the developer.

The case doesn’t turn on any particularly interesting legal principles or make any new law. But the facts, set out in careful detail by Dove J, illustrate precisely the concerns that lay behind my attempt just now to establish some common ground:

The policy background is not straightforward, with a changing position both at borough level and at London Plan level.

The Mayor has set out criteria in his 2017 affordable housing and viability SPG for different tenures of affordable housing, including social rent (target rents determined through the national rent regime), affordable rent (rent controls requiring a rent of no more than 80% of the local market rent), intermediate (available for rent or sale at a cost above social rent but below market levels – and eligible only to households whose annual income is within a defined range) and intermediate London Living Rent (only available to households renting with a maximum income of £60,000 without sufficient current savings to purchase a home within the local area).

The adopted London Plan requires boroughs to seek the “maximum reasonable amount of affordable housing…when negotiating on individual private residential and mixed use schemes, having regard to” a number of factors, including “development viability” and the “availability of public subsidy”.

Within the Elephant & Castle area, Southwark’s adopted plan seeks a minimum requirement of 35%, on the basis of a split of 50% social rented and 50% intermediate housing. Its emerging plan seeks, in relation to build to rent developments, a different tenure split for the 35%: social rent equivalent (ie social rent level but not managed by registered provider) 34% minimum, affordable rent (aka discount market rent) capped at London Living Rent equivalent 52% minimum, affordable rent (aka discount market rent) for household incomes between £60,000 and £90,000 per year 14% minimum. The lack of social rent reflects the specific nature of build to rent developments, where it is more efficient for all of the housing to remain under single management rather than for a separate registered provider to be introduced.

At the time Delancey’s application first went to committee on 16 January 2018, its proposal was 36% affordable housing based upon habitable rooms, with the 36% made up as follows: 10% social rent equivalent, 46% London Living Rent, 43% discount market rent. The non policy compliant offer (in terms of tenure split) was based on an agreed viability assessment. Despite a recommendation for approval, members deferred a decision until a meeting scheduled for 30 January 2018 at which they intended to formulate reasons for refusal. The day before the follow-up meeting the developer made further proposals in relation to the affordable housing offer and the application was deferred to a subsequent meeting.

The revised proposal was to replace 33 social rent equivalent units with 74 socially rented units, all to be located on the western part of the development and to be owned and operated either by the borough or by a registered provider. This changed the tenure split (of the 35% affordable housing dwellings) to: social rent 24.9%, London Living Rent 27.9%, discount market rent 47.2%.

In June 2018 the offer was increased again. The developer’s consultants indicated that following “in-principle agreement from the GLA to provide grant funding towards the proposed scheme” the number of social rent units could be increased to 116 homes, or 38.1% of the 35% of the units that were to be affordable.

The application was approved at a committee meeting on 3 July 2018. It was acknowledged in the report that the proposed tenure split was still not policy compliant but was justified by way of the agreed viability appraisal. The report also noted that there would need to be a fallback arrangement in the section 106 agreement to cater for the possibility that the developer might choose after all to develop the western part of the development on a for sale rather than for rent basis (in which case the affordable housing requirement for that part of the site would return to 50% social rented, 50% intermediate).

If all of this does not start to give an idea of the inevitable complexity of negotiations on a scheme such as this, then consider the viability appraisal. As is common with a significant longterm development, where application of the more straightforward benchmark land value plus developer’s profit approach does not reflect accurately the financial modelling of a project over time, viability was judged against a minimum internal rate of return for the developer.

The latest RICS draft guidance defines internal rate of return (or “IRR”) as follows:

The rate of interest (expressed as a percentage) at which all future project cash flows (positive and negative) will be discounted in order that the net present value (NPV) of those cash flows, including the initial investment, be equal to zero. IRR can be assessed on both gross and net of finance.”

However, unless I have missed it, there is no guidance anywhere as to when an IRR approach is appropriate and how to arrive at and test the inputs and modelling.

The agreed benchmark was 7.15% IRR, with annual growth to 11% over the construction period. Review mechanisms in the section 106 agreement provide that 50% of any excess are to be applied to increasing the affordable housing provision up to a policy compliant level/tenure split.

The claimant had three grounds of challenge. The first turned on an alleged inaccuracy in the way that the GLA’s offer of funding had been reported – it had not been formally confirmed and discussions were at an “in principle stage”. The second alleged that one of the detailed mechanisms in the section 106 agreement departed from the relevant head of term in the committee resolution. The third related to the mechanism in the section 106 agreement for determining the affordable housing to be provided if the western part of the site turned into a “for sale” development, but a deed of variation had been entered into after the challenge was brought, largely correcting the error that had been identified.

Dove J rejected each of the grounds, whilst accepting that each was arguable. (1) The report did not materially mislead members. (2) The section 106 mechanism was not outside the scope of the committee resolution (“True it is that the solutions arrived at are not a literal interpretation of paragraph 364 [of the report to committee], in that they do not include for the provision of land and a substantial cash dowry to construct the social rented units but, in my judgment, that was not required in order to remain within the scope of the delegation granted by the members”). (3) The approach to the fallback (“for sale”) scenario was “entirely rational and appropriate”. Part of the claimant’s criticism of the arrangements turned on whether the additional affordable housing in these circumstances should be social rented units rather than the social rented equivalent units provided for. The judge saw nothing relevant in the distinction:

In terms of the matters raised by the Claimant the quality of tenure enjoyed by tenants in social rented equivalent properties are, as the nomenclature suggests, equivalent to those in social rented properties. Of course, there may well be nuanced differences between them as a consequence of them being separately defined. Furthermore, they will be managed in different ways as the definition implies. Be all of this as it may, in my view the important point is that the requirement of the officers’ report was a review in terms of affordable housing, and whether the additional habitable rooms were to be provided as social rented or social rented equivalent accommodation was not identified as being in any way a critical point upon which the delegation to the officers of authority to enter into the section 106 obligation turned. Put another way, whatever may be the nuanced differences between social rented equivalent property and social rented units that was not identified as a key requirement in relation to the review mechanism contemplated were the developer to take up the fall-back scenario.”

Will the new guidance make any of this more straight forward? I doubt it. Would proper funding for social rent and social rent equivalent housing? Of course it would.

Old Oak and Park Royal Local Plan

The recent NPPF and PPG changes of course seek to move the viability spotlight to the point at which sites are allocated for development. The Old Oak plan was examined last year under the previous NPPF but viability matters were still centre stage and the inspector’s findings may be an indicator of the detailed scrutiny that is likely to be given to the viability in particular of strategic sites (taken together with proposed policy requirements in terms of infrastructure delivery and affordable housing).

One of the key issues for the inspector was whether the proposed allocation of the 54 acre Cargiant site for residential and associated development was viable. Cargiant had itself attempted development of its site in the past. It had concluded that it would be unviable to contemplate relocating or extinguishing its business and carrying out the development – and took the position that there was no reasonable prospect within the plan period of the Old Oak and Park Royal Development Corporation (“OPDC”) being in a position to carry out such proposals, even by resorting to compulsory purchase and even with the benefit of £250m Housing and Infrastructure Fund monies which had been agreed in principle to be allocated by MHCLG.

My firm acted for Cargiant and so I will restrict myself to pointing out the level of detail to which the inspector went in his interim findings on viability of Cargiant site proposal (10 September 2019) before concluding that the allocation would be unviable and therefore unsound.

The day after the general election, on 13 December 2019, the OPDC announced that it would change its proposals, which will now leave Cargiant in place:

New focus for Old Oak and Park Royal regeneration:

The Old Oak and Park Royal Development Corporation (OPDC) has today set out a revised approach to deliver tens of thousands of new homes and jobs through collaboration with major public sector landowners.

The regeneration of Old Oak, Park Royal and surrounding areas in west London, has the potential to deliver 25,500 new homes and 65,000 jobs over the next 30 years. OPDC has already approved plans for over 5,000 homes including 1,500 already completed or being built.

The shift in approach has been triggered by recent, rapid increases in industrial land values in west London which mean that it is currently not financially viable to deliver OPDC’s early regeneration plans at Old Oak North. This area, close to the planned new HS2 interchange station, includes the 54-acre site that is owned and operated by Cargiant, which had originally been earmarked for development.

Earlier this year, the Planning Inspector, in his interim report on the OPDC’s draft Local Plan, de-designated the Cargiant site from Strategic Industrial Land, but also concluded that Old Oak North had become commercially unviable for residential-led development at this time.”

Whilst this situation might be taken to be an example of how viability matters can indeed in practice be taken into account at the plan-making stage, I do have concerns:

⁃ There is now a bigger onus on authorities to carry out proper viability work, including work to a sensible level of detail on strategic sites (albeit often with assistance from those promoting those sites for development), and is it actually going to be done?

⁃ Where it is not done, delays will occur in the examination process. At Old Oak, the necessary work had not been done and there was a significant hiatus whilst it was commissioned.

⁃ Development proposals are often not sufficiently worked up, at the stage that the plan is being prepared, so as to enable a sensible viability appraisal to be undertaken. And will developers be prepared always to come clean at the allocation stage as to the challenges they are facing in making the numbers stack up?

⁃ Will there always be participants in the local plan examination process with the motivation and resources to put authorities to proof on the work that has been carried out? If Cargiant hadn’t taken its stance (entailing lawyers and a team of consultants to challenge much of the inputs) I suspect the allocation would have been confirmed without challenge – and then proved over time to be undevelopable.

The next blog post will be shorter, I promise.

Simon Ricketts, 4 January 2020

Personal views, et cetera

Pic credit: Bizarro Comics
