CIL Life

One of the many frustrating aspects of the Community Infrastructure Levy regime is the confusing and limited nature of any right to appeal, which is particularly concerning given the varying interpretations given to the Regulations by different collecting authorities.

The first difficulty is working out what the appeal route in any particular situation is.

Appeals lie to the Valuation Office Agency in relation to:

⁃ Regulation 114 (where an interested person has asked the collecting authority for a review of the chargeable amount as is aggrieved at the decision on the review)

⁃ Regulation 115 (apportionment of liability)

⁃ Regulation 116 (charitable relief)

⁃ Regulation 116A (exemption for residential annexes)

⁃ Regulation 116B (exemption for self-build housing).

Recent VOA appeal decisions are here.

Appeals lie to the Planning Inspectorate in relation to:

⁃ Regulation 117 (decisions by the collecting authority to impose a surcharge)

⁃ Regulation 118 (determinations by the collecting authority of a deemed commencement date)

⁃ Regulation 119 (imposition by the collecting authority of a CIL stop notice).

Recent Planning Inspectorate appeal decisions are here.

A common theme in relation to the VOA and PINS appeals decisions is the frequency of misunderstandings as to the CIL regime on the part of those carrying out minor developments, the frequency of notices being missed or overlooked and forlorn attempts to avoid or reduce liability at a stage when development has already commenced and the horse has bolted.

Appeals can then proceed to the High Court if either of the parties considers that the decision of the VOA or PINS was wrong in law.

In relation to decisions of the collecting authority which are not listed above, for instance as to whether any exemption or relief should be granted other than charitable relief, the exemption for residential annexes and self-build housing – say social housing relief – the only possibility for challenge is for by way of an application to the High Court for judicial review. Not only is that a disproportionately cumbersome route for challenge when the issue could surely be dealt with by the VOA or PINS but, given that the possibility for claiming a relief or exemption is lost if it is not granted before development is commenced, few developers have the luxury of being able to wait for resolution of a disagreement over the relief or exemption before starting construction.

Surely all of this needs looking at again and simplifying as part of the Government’s current review.

I started thinking about all of this when reading what may be only the third High Court ruling in relation to CIL liability issues, R (Giordano Limited) v London Borough of Camden (Lang J, 13 December 2018). It’s a pretty straightforward case but I’m still not sure whether there was a VOA decision (and if not why the challenge was allowed to proceed) – maybe someone out there can help?

The issue was whether, in determining the relevant floorspace within the chargeable development, the test in Regulation 40 (7) (ii) was met as to whether there were “retained parts where the intended use following completion of the chargeable development is a use that is able to be carried on lawfully and permanently without further planning permission in that part on the day before planning permission first permits the chargeable development.” The floorspace represented by such parts wouldn’t attract CIL.

The claimant was intending to implement a planning permission for “change of use of third floor offices (class B1a) and vacant first and second floors (class B8) to create 3 x three bedroom flats.” Having received a liability notice for £547,419.09, it argued that the test was met because there was a previous planning permission which had been lawfully commenced for “change of use of third floor offices (class B1a) and vacant first and second floors (class B8) to create 6x two-bedroom flats (class C3), including rear extensions at first, second, third and fourth floors and associated external alterations.

Under the previous (pre-CIL) permission, the rear extension and alterations to the elevations of the building had been completed, and steel beams refitted internally, but the first, second and third floors were just stripped out, unpartitioned floors and were not yet capable of being used for residential purposes.

The claimant was attempting to rely on the floorspace deduction provided for in Regulation 40 (7) (ii) because it couldn’t show that any part of the building had been lawfully occupied for at least six months in the previous three years.

Lang J found that because the floorspace was currently incapable of being used for residential purposes it did not meet the test – a “potential” future use was not sufficient.

Stepping back, I would say that was a pretty large windfall for the local authority!

The only other two High Court cases I’m aware of are:

R (Orbital Park Swindon Limited) v Swindon District Council (Patterson J, 3 March 2016), where the claimant succeeded in mitigating its potential CIL liability by securing two separate planning permissions for its proposed works to a retail store, one of which permissions, for the introduction of additional space by way of a mezzanine, was not liable for CIL.

Patterson J had no difficulty with the deliberate CIL mitigation strategy adopted:

There is […] no manipulation of the system for any ulterior and/or illegal motive in accordance with the submissions of the defendant. Rather, the claimant has taken advantage of the legislative scheme which permits it to submit, in this case, two separate planning applications for each act of operational development that it wished to pursue. If it was not the intention of the legislature to permit that to occur then it is for the legislature to change it. At present, in my judgment, that is the consequence of the current statutory scheme.”

R (Hourhope Limited) v Shropshire Council (HHJ David Cooke, 2 March 2015), where the claimant failed in its submissions that the “in lawful use” requirement for deduction of floorspace would be met by anything less than actual use – it was not sufficient that the building (a former pub) was still available for lawful occupation, or that there was some residual storage of items left behind from when the pub had closed.

Is anyone aware of any others?

MCIL2

While talking about CIL, I thought it might be worth a brief post script about the Mayor of London’s MCIL2 (previously covered in part of my 9 November 2018 blog post An Update On CIL: Reform Promised, Meanwhile Continuing & Increasingly Expensive Uncertainties). The report of the examiner, Keith Holland, has now been published, recommending, with one minor modification, that the submitted charging schedule is appropriate, meaning that we can expect it to be adopted and take effect on 1 April 2019.

Despite the increasingly big question mark that there must be over whether Crossrail 2 (the basis for MCIL2) is politically deliverable at present (see my 1 July 2017 blog post Crossrail 2, Where Are You?) Mr Holland has no difficulty on that score:

In 2016 the National Infrastructure Commission recommended that Crossrail 2 be taken forward as a priority with the aim of opening in 2033. Costings for the project have recently been subject to an independent review. The results of the review are not yet public and at this stage there is no formal government approval for Crossrail 2. However, the need for new infrastructure to support the region’s growth was endorsed by the Secretary for State for Transport in July 2017 and there is no doubt that an extremely strong case can be made for Crossrail 2. Moreover, there is general endorsement for Crossrail 2 from those making representations.”

Of course many of us want to see Crossrail 2 proceed. But what if it doesn’t? That’s a lot of money being raised without a defined objective as to the transport projects to which it is to be applied and surely it would be wrong for it to end up being used, for instance, to address cost overruns in relation to Crossrail 1?

Simon Ricketts, 15 December 2018

Personal views, et cetera

Charles Alfred Meurer, Still life with money, pipe and letters, 1914

An Update On CIL: Reform Promised, Meanwhile Continuing & Increasingly Expensive Uncertainties

Well done for getting past the heading.

Someone recently asked me whether the Government ever changes its proposals as a result of a consultation process. For an example of just such a thing, I was able to point to the Government response to supporting housing delivery through developer contributions: a summary of consultation responses and the Government’s view on the way forward (29 October 2018). The proposals set out in the Government’s March 2018 consultation paper (summarised in my 10 March 2018 blog post Developer Contributions, CIL, Viability: Are We Nearly There Yet?) have been modified significantly as a result of consultation, mostly for the better in my view at least.

This blog post focuses on the changed proposals and then looks at some looming issues facing phased developments in areas where charging authorities are looking to increase rates (I’m focusing on the Mayor of London’s MCIL2 but I’m sure the issue is of wider application).

The Government response

The document acknowledges some of the flaws of the current system:

The complexity and uncertainty of the current system of developer contributions is acting as a barrier to the delivery of housing. The system does not react quickly to changes in market conditions or allow local authorities to effectively secure the contributions needed to support new development. It is also not as transparent as it should be; local communities are not clear what infrastructure is provided alongside new development. And the current system could also be more effective in securing funding towards strategic infrastructure and supporting cross boundary planning.”

The Government intends to consult on draft regulations “later this year” to implement the changes set out in the March 2018 consultation document, as now modified. It is important to note that the Government will “also consider whether changes could be made to the Community Infrastructure Levy to incentivise the build out of developments.” (perhaps something that Sir Oliver Letwin might have looked at but…).

The Government has now modified its proposed changes as follows:

1. The previous proposal to replace charging authorities’ current statutory consultation requirements, in relation to proposed charging schedules, with self-certification as to whether it has sought “an appropriate level of engagement” has been amended. The Government “intends to take forward a modified proposal to ensure that regulations continue to require charging authorities to consult on draft charging schedules, whilst removing the current statutory requirement for two separate rounds of consultation in every circumstance.”

2. The pooling restriction will now be removed in its entirety in all areas. Hooray! Although of course there is the risk that tariff-type section 106 contribution requirements will again become more prevalent, in my view the pooling restriction led to many unnecessary problems and uncertainties, which would have continued under the Government’s March 208 idea of only removing the restriction in in areas where specified criteria were met.

3. The Government had intended to introduce a two month grace period for developers to submit a commencement notice in relation to exempted development, to address disproportionately severe problems arising for eg self-builders who, if they fail to meet procedural requirements, find not only that they fail to qualify for any exemption but that all CIL due has become immediately payable. The Government will not now introduce the grace period (which local authorities considered could lead to practical complications) but instead will be “making changes to the penalties associated with the failure to submit a Commencement Notice prior to development being started. This will ensure that any penalty is set at a proportionate level and will not result in the whole liability becoming payable immediately.”

There may also be more guidance as to potential exemptions: “A number of responses sought additional exemptions to address the unintended viability impacts of Levy liabilities on particular forms of development. The Government will consider how guidance could be used to manage these effects by encouraging authorities to take account of these issues when setting Levy rates and choosing how they use existing powers for discretionary social housing relief. In addition, the Government has already committed to bring forward legislation to exempt Starter Homes from the Community Infrastructure Levy.”

4. The complicated proposal in the March 2018 consultation document that charging schedules might be set with reference to the existing use of land has been dropped. “However, the Government has reviewed this proposal and considers there are existing flexibilities in the Community Infrastructure Levy Regulations that, through the use of differential Levy rates, will allow local authorities to go some way towards achieving the objective of the proposed reform. The Government therefore proposes to make changes to guidance to support local authorities to set differential rates more effectively.

5. At the time that it publishes the draft amendment regulations, the Government intends to “consult on changes to indexation of Levy rates and the way in which it would be implemented“. Its current preference is to index CIL rates “for residential development to the House Price Index using local-level data on an annual basis” and to index rates for non-residential development to the Consumer Price Index. It recognises the transitional issues that will arise.

6. The Government still intends to remove the restriction in relation to section 106 obligations that relate to an infrastructure project or type of infrastructure that is set out in the authority’s Regulation 123 list. “New reporting standards, which are set out in the Infrastructure Funding Statement, will address concerns about double dipping by ensuring that there is transparency over how developer contributions from both CIL and section 106 planning obligations are being used, rather than by placing formal restrictions in regulations.” We need to watch this one with care!

In relation to one specific issue that often leads to wrangles: “The Government also recognises the need to address existing uncertainty around using section 106 planning obligations to collect monitoring sums. The Government therefore intends to take forward proposals to make clear that local authorities can seek a fee from applicants towards monitoring planning obligations. In developing these proposals, the Government will consider how best to ensure that monitoring sums are set at an appropriate level.”

7. The Government had intended to give combined authorities and joint committees with strategic planning powers the ability to charge a Strategic Infrastructure Tariff. “The Government has decided to take forward a modified proposal, to enable Combined Authorities with strategic planning powers to take forward a Strategic Infrastructure Tariff, and to encourage groups of charging authorities to use existing powers to more effectively support the delivery of strategic infrastructure through the pooling of their local Community Infrastructure Levy receipts. In the longer term, the Government will bring forward proposals for allowing joint planning committees to charge the tariff, and will review options for giving other groups the power to levy a Tariff.”

The Government had also included a final “catch all” question seeking any other comments. Particular issues that were raised in responses included “the definition of gross internal area, implementation of the Levy in particular circumstances (such as in relation to development that takes place in a number of phases or there is a change of use), and the operation of exemptions and reliefs, indexation and in-kind payment.

Issues such as these are indeed causing much uncertainty.

The implications of increased rates/MCIL2

Whilst we wait for eventual reform of the system, of more immediate focus are the implications of gradual increases by charging authorities in CIL rates.

In London, the Mayor of London is waiting for the inspector’s report following the examination into the draft charging schedule for MCIL2. MCIL2 is proposed to part-fund Crossrail 2, in the way that MCIL1 (together with a related policy of seeking section 106 contributions in relation to some areas and types of development) is part-funding Crossrail 1.

The charging schedule for MCIL1 was adopted on 1 April 2012 (which is why there are many section 106 agreements and permissions dated March 2012, as developers and boroughs scrambled to ensure that permissions were not subject to the levy!).

This table sets out borough by borough the significant sums of money that MCIL1 has now raised:

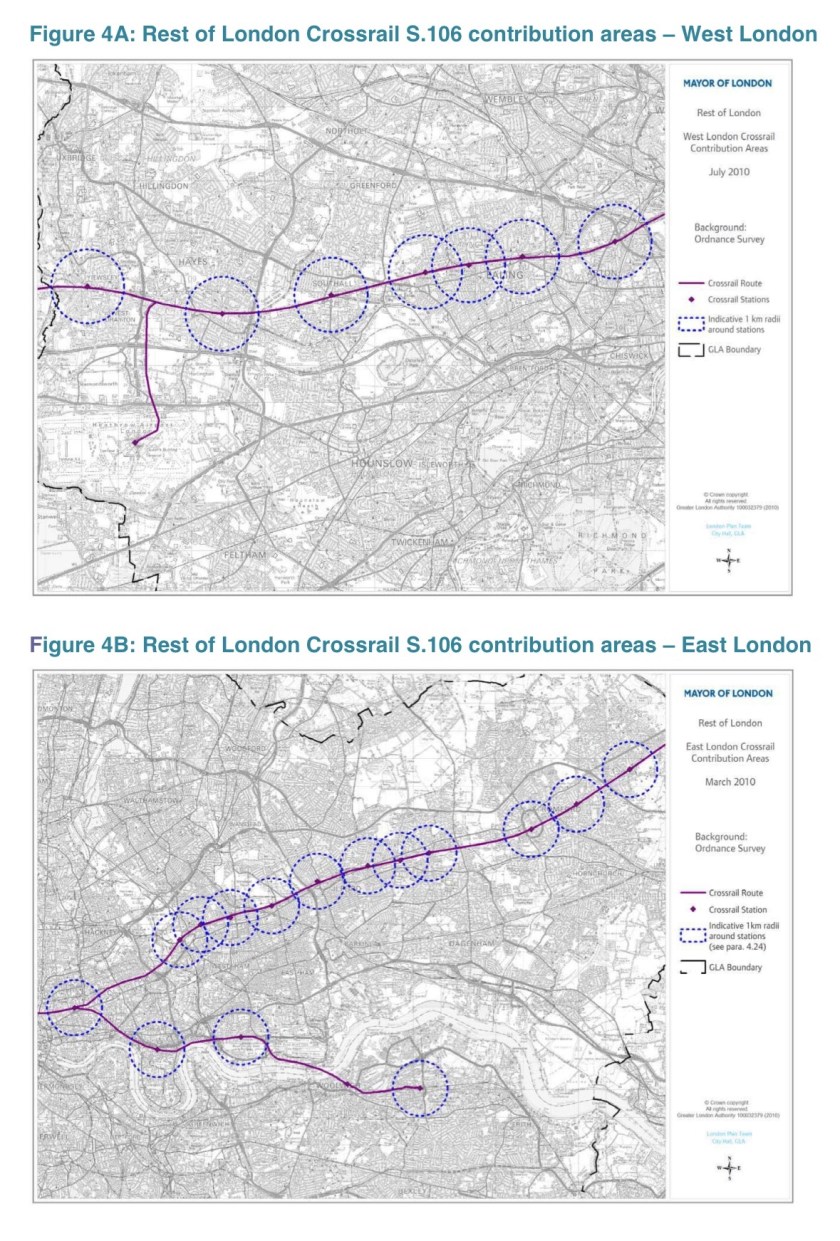

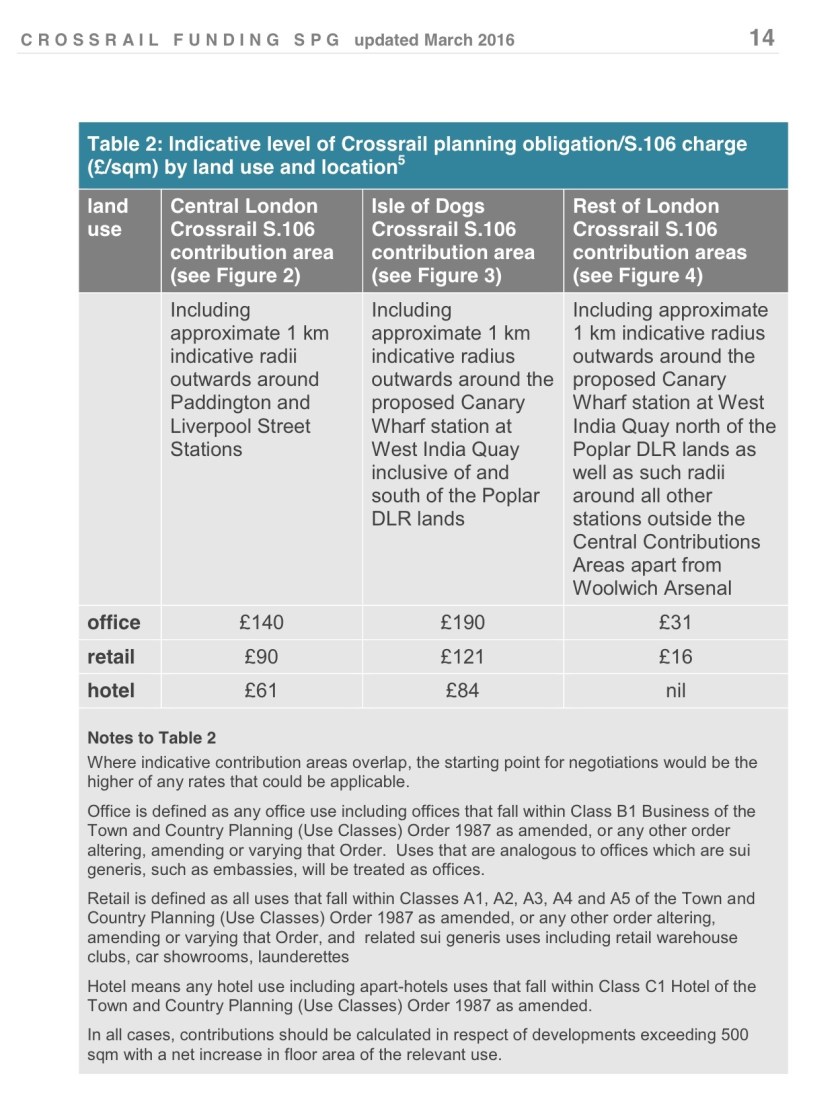

The section 106 contributions policy for Crossrail (set out in the Mayor’s Crossrail Funding SPG, updated March 2016) predated MCIL1 and provided for section 106 contributions based on the following table and plans:

The standardised wording included in relevant section 106 agreements provides that any MCIL1 which is payable reduces the contributions which are required to be made under the relevant section 106 agreement.

As long as the inspector’s report is received on time and gives it a clean bill of health, MCIL2 will be adopted on 1 April 2019. The changes in rates, compared to where the 2012 rates currently sit with indexation applied, are mostly not huge, but they are significant in some areas. In areas where the increases are material, I am sure we will see a similar rush to beat the deadline.

One uncertainty is of course whether the examination inspector will accept a charging schedule that is predicated on Crossrail 2 coming forward. Little has progressed on the project since my 1 July 2017 blog post, Crossrail 2: Where Are You? We are all still awaiting outcome of an independent affordability review being chaired by Mike Gerrard. The Mayor is hedging his bets, simply indicating:

Should the Crossrail 2 project not be taken forwards, the Mayor would be able to apply the MCIL 2 proceeds to fund other strategic infrastructure.”

Assuming that MCIL2 is waved through and the charging schedule is adopted on 1 April, the relevant point at which it takes effect is determined by everyone’s least favourite phrase in the CIL Regulations: “at the time planning permission first permits the chargeable development“.

For a non-phased permission, this is the date of the permission – easy.

For a phased outline permission, this is either “the date of final approval of the last reserved matter associated with that phase” or “if earlier, and if agreed in writing by the collecting authority before commencement of any development under that permission, on the day final approval is given under any pre-commencement condition associated with that phase“.

For a phased full permission, this is either “the day final approval is given under any pre-commencement condition associated with that phase” or “where there are no pre-commencement conditions associated with that phase, on the day planning permission is granted“.

It will be seen that (1) the revised charging schedule is liable to bite in respect any phase of an existing phased permission if sufficient progress has not been made in relation to reserved matters or discharging pre-commencement conditions in relation to that phase and (2) that there are inherent uncertainties in the drafting, eg

⁃ What does “associated with that phase” mean?

⁃ Does “any” mean “any” or, in fact, “all“?

As a final example of the inadequacies of the legislation: where there is a phased permission and a revised charging schedule is subsequently adopted, the only indexation that applies is of the amount arising from the initial charging schedule up to the end of the year prior to the date of the permission. There is no further indexation through to commencement of development or any indexation of the revised charging schedule insofar as it applies to the phases! Would it not be simpler and more predictable if indexation were not to stop at the initial grant of the permission and instead to continue through to final approval (or even commencement of development) in relation to each phase, but if the potential application of revised charging schedules were removed?

In case anyone has made it down this far…

In conclusion:

⁃ the proposed reforms, and most recent proposals, look to be mainly positive

⁃ but the whole regime really does still need simplifying: to state the obvious, significant liabilities can unexpectedly arise for the unwary – and large sums of money can turn on uncertain issues of interpretation.

Simon Ricketts, 9 November 2018

Personal views, et cetera

Crossrail 2, Where Are You?

We’ve got some work to do now.
George Osborne’s March 2016 budget indicated that the then Government would be “investing in the infrastructure that will deliver economic growth for the next generation” by a number of measures, including “securing London’s future infrastructure by giving the green light for Crossrail 2 to proceed. The government will provide £80 million to develop the project with the aim of bringing forward a Hybrid Bill this Parliament”.


There have been rumours that the Treasury or Department for Transport subsequently have not yet been convinced of the business case but, whatever the reason (the twin challenges of Brexit and the need to devote resources to Northern Ireland to prop up a new born minority government? Politics = events, dear boy, events), the project’s absence from the Conservatives’ 2017 manifesto and subsequently from the Queen’s Speech on 21 June has been hugely disappointing.
Perhaps given Mr Osborne’s new job it is no surprise that on the day of the Commons debate on the Queen’s Speech, 29 June, the London Evening Standard set out its concern in a strongly written editorial, but the points are surely well made.
Delay to the project would have a series of harmful consequences:
– Postponement of the commuting benefits and congestion relief that it will bring. Given the need to provide additional capacity at Euston ready for the opening of HS2 in 2033, it is time critical (see City am’s 28 June 2017 piece).
– Loss of the opportunities that it will open up for additional housing and employment development around stations on the route, including opportunities for Transport for London to explore the possibilities for land value capture mechanisms. The Crossrail 2 Growth Commission confirmed in its 2016 report that the project could unlock 200,000 additional homes and 200,000 additional jobs. Without Crossrail 2, how will further housing come forward at the scale that is needed? In this uncertain period, are key sites going to lie fallow or developed at less than the scale that could be achieved with better rail connectivity?

– The unnecessary cost of delay, estimated by Crossrail 2 managing director Michele Dix at £2bn a year.

– Extended blight that will be caused along its current route, safeguarded in 2015 and shown on this interactive map.

– The uncertainty that has now been created for the impending replacement London Plan, the first draft of which we will see in November. The implications of Crossrail 2 are so significant that might the Mayor have to publish “with and without Crossrail 2” draft policies? How can the likely effects of the plan be properly assessed with such a question mark over Crossrail 2?

The Mayor commenced consultation on 26 June 2017 in relation to his Mayor of London Community Infrastructure Levy 2 Preliminary Draft Charging Schedule (MCIL2 PDCS). MCIL1, which was adopted on 1 April 2012, was directed towards funding Crossrail 1. MCIL2 is directed towards funding Crossrail 2 and the Mayor intends for it to be adopted in April 2019.

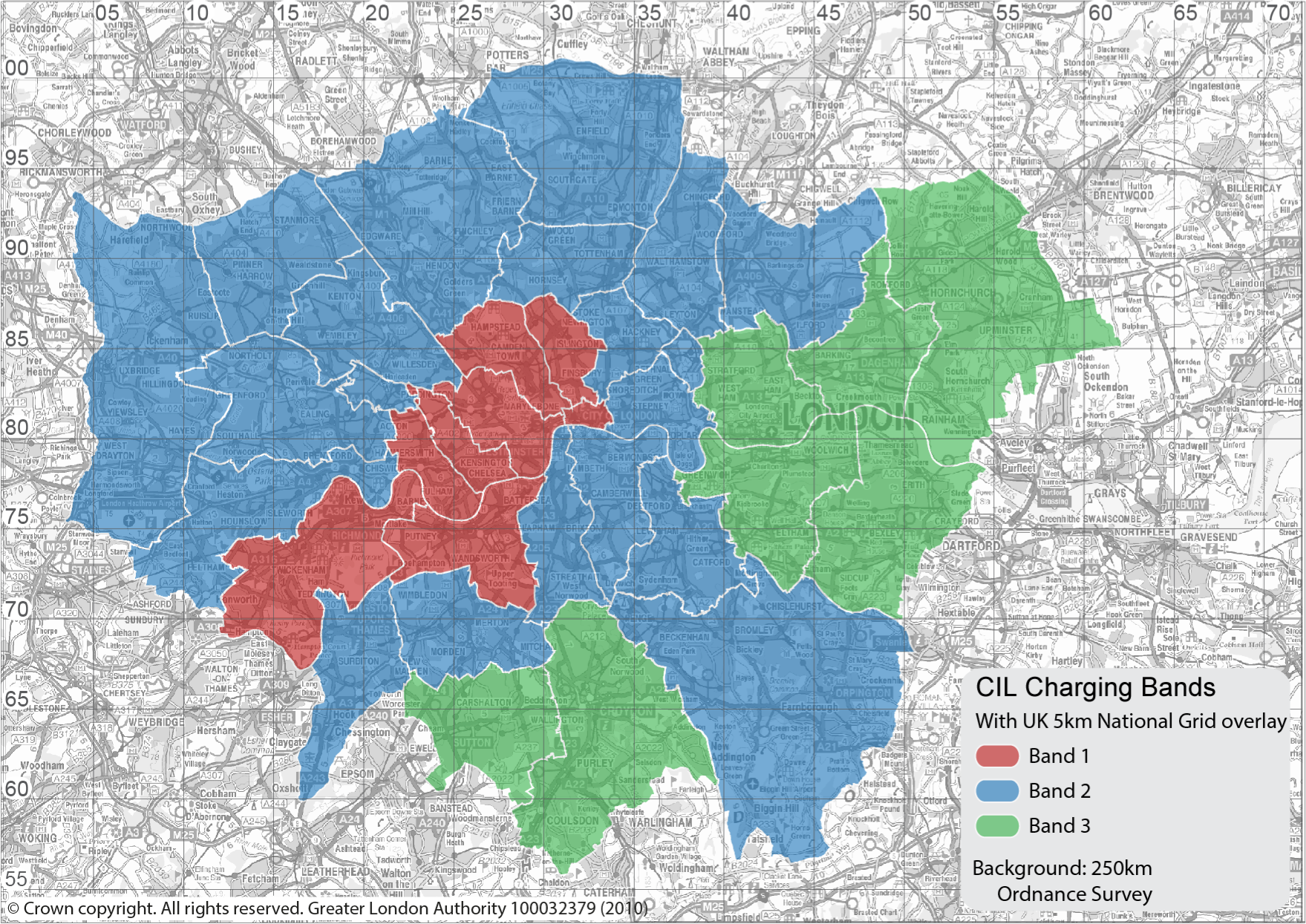

The proposed per sq m rates are £80 for band 1, £60 for band 2 and £25 for band 3, save that in central London and the Isle of Dogs, the rates for office, retail and hotel uses will be £185 for offices, £165 for retail and £140 for hotel uses.

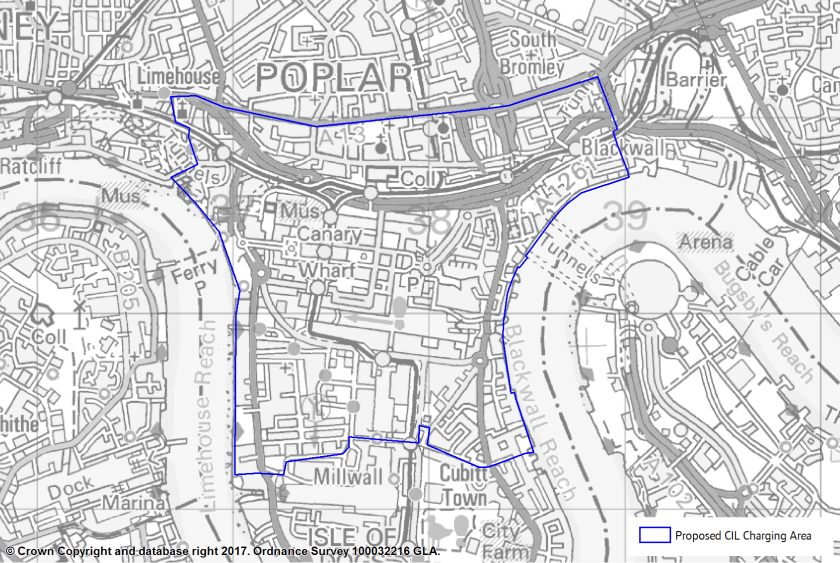

Central London.


Isle of Dogs

The Mayor’s supporting information says this about the current funding position for Crossrail:
Since the 2016 Budget, Transport for London, the Greater London Authority and the Government have been working to develop a funding package for the project as part of the development of a strategic outline business case. The London contribution to the costs of Crossrail consists of four funding sources:

    * Crossrail 2 net operating surplus – i.e. the net impact of Crossrail 2 on TfL’s rail revenues


    * over station development – proceeds from development of land and property initially required for construction (development related with Crossrail 2 will pay Mayoral CIL 2 on the same basis other developments)


    * a Business Rate Supplement (BRS) (once the current BRS repays Crossrail 1 related debt)


    * a Mayoral Community Infrastructure Levy (MCIL2).”


MCIL2 is intended to meet approximately 15% of the project’s costs. What if Crossrail 2 does not go ahead? The document states:

“Negotiations on the Crossrail 2 scheme are still underway and there is no agreed funding package at present. However, MCIL2 does need to be brought forward now to avoid a charging gap at the end of Crossrail 1 construction and to allow for early funding of the Crossrail 2 scheme. Should no funding deal be achievable, the Mayor will be able to apply the MCIL2 proceeds to fund other strategic transport projects for which there is a significant funding gap.
Crossrail 2 is also a key strand of the Mayor’s draft transport strategy published on 21 June 2017: “It
 will enable London’s highly productive economy to continue to grow by helping 270,000 more people get into the centre in the morning peak. It will thereby support 200,000 new jobs, as well as unlocking 200,000 additional new homes – more than 30 per cent of them outside London”

So what is happening behind the scenes? Will Crossrail 2 emerge in a leaner form? A City am story on 26 June asserts (denied by Crossrail 2) that a revised business case provided to the Government in March had dropped the proposed station at Kings Road Chelsea (the subject of a vociferous celebrity-backed campaign) and that possible stations at Turnpike Lane and Balham have been replaced by Wood Green and Tooting Broadway options respectively. The continued speculation without any real information, isn’t helping anybody.

What political weight, if any, does the National Infrastructure Commission still have? George Osborne (him again) established the NIC in October 2015 to “determine Britain’s infrastructure priorities and hold governments to account for their delivery” and appointed Lord Andrew Adonis as its chairman. NIC’s support of Crossrail 2 was hugely influential in the lead up to that March 2016 announcement. It set out on 26 June 2017 its top 12 infrastructure priorities, with Crossrail 2 featuring strongly: “The Government should by the end of 2017 publish a plan, agreed with the Mayor of London, for the funding and phased construction of Crossrail 2, and for securing the necessary parliamentary consent, taking account of the recommendations in the NIC’s Transport for a World City report.”
If this stasis goes on much longer I may even start to get nostalgic about all of those photos of George Osborne in high vis and hard hat…
Simon Ricketts, 1 July 2017

Personal views, et cetera
